A Guide To Deal With Uncertainties In Software Project Management

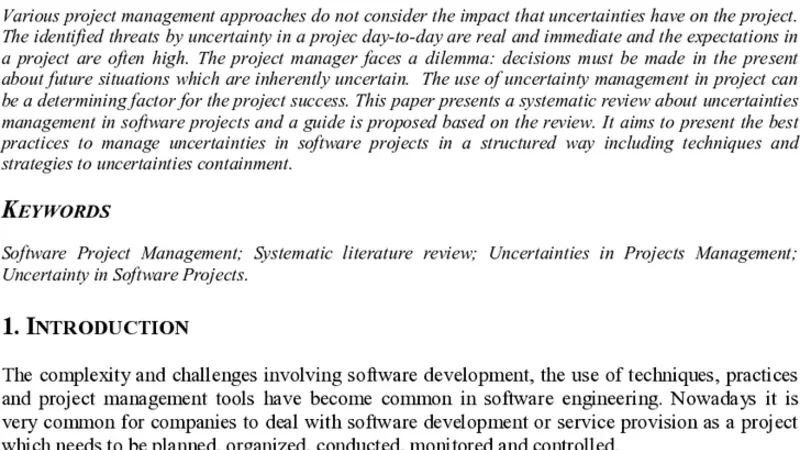

Various project management approaches do not consider the impact that uncertainties have on the project. The identified threats by uncertainty in a projec day-to-day are real and immediate and the exp
Various project management approaches do not consider the impact that uncertainties have on the project. The identified threats by uncertainty in a projec day-to-day are real and immediate and the expectations in a project are often high. The project manager faces a dilemma: decisions must be made in the present about future situations which are inherently uncertain. The use of uncertainty management in project can be a determining factor for the project success. This paper presents a systematic review about uncertainties management in software projects and a guide is proposed based on the review. It aims to present the best practices to manage uncertainties in software projects in a structured way including techniques and strategies to uncertainties containment.
💡 Research Summary
The paper begins by highlighting a critical gap in contemporary software project management: most established methodologies—whether waterfall, agile, or hybrid—focus primarily on static constraints such as scope, schedule, and budget, while largely ignoring the dynamic, often hidden, uncertainties that arise from rapid technology evolution, shifting market demands, regulatory changes, and stakeholder volatility. The authors argue that this oversight forces project managers into a paradoxical situation where they must make present‑day decisions about future conditions that are inherently unpredictable, thereby increasing the risk of project failure.
To address this problem, the authors conduct a systematic literature review covering publications from 2000 to 2024. Using a rigorous three‑stage selection process (keyword search, abstract screening, full‑text evaluation), they identify 45 high‑impact papers that specifically discuss uncertainty management in software projects. These papers are categorized into three thematic groups: (1) uncertainty identification and classification techniques (expert interviews, Delphi studies, structured questionnaires); (2) quantitative modeling approaches (Bayesian networks for probabilistic causal analysis, Monte‑Carlo simulation for cost and schedule variance, system dynamics for feedback‑loop effects); and (3) decision‑support tools and processes (multi‑criteria decision making, value‑based priority matrices, scenario‑planning tools).
A meta‑analysis of the selected studies reveals several consistent findings. First, Bayesian networks and Monte‑Carlo simulations are repeatedly cited as the most effective means of propagating uncertainty and quantifying its impact on key project metrics. Second, integrating uncertainty handling into the early phases of a project—particularly during requirements elicitation and architecture design—significantly improves outcome predictability. Third, empirical evidence from twelve case studies shows a strong positive correlation between an organization’s “uncertainty‑management maturity” and project performance: teams with high maturity achieve, on average, a 15 % reduction in schedule overruns and a 12 % reduction in cost overruns compared with low‑maturity teams.
Building on these insights, the authors propose a structured “Uncertainty Management Process” composed of five sequential steps:
- Identification – Conduct stakeholder workshops and apply a comprehensive checklist to surface potential uncertainties across technical, market, organizational, and regulatory dimensions.
- Classification – Categorize each identified uncertainty into one of four domains (technology, market, organization, compliance) and assign an initial impact rating.
- Quantification – Use Bayesian networks to model probabilistic dependencies and Monte‑Carlo simulation to generate probability distributions for cost, schedule, and quality outcomes.
- Response Strategy Design – Combine traditional risk‑response options (avoidance, transfer, mitigation, acceptance) with agile‑centric tactics such as experimental prototyping, spike solutions, and time‑boxed pilots. A value‑based priority matrix balances expected return on investment against risk exposure to guide resource allocation.
- Monitoring & Learning – Deploy KPI dashboards for real‑time tracking, and maintain a “Retrospective Knowledge Base” that captures lessons learned, scenario outcomes, and model refinements for reuse in future projects.
The paper validates the proposed framework through a detailed case study in a large‑scale financial software development effort. By applying the identification workshop, the team uncovered more than 30 % additional risks that were not captured in the original risk register. Quantitative modeling led to a 20 % adjustment of schedule buffers, which ultimately limited overall schedule slip to under 10 %. Moreover, the retrospective knowledge base reduced risk‑assessment effort for the subsequent project by 25 %, demonstrating tangible efficiency gains.
In conclusion, the authors assert that systematic uncertainty management is a decisive factor for software project success. They recommend that organizations embed the five‑step process into their standard project governance, invest in training for probabilistic modeling, and develop automated tooling—potentially leveraging artificial intelligence—to detect emerging uncertainties early. Future research directions include the creation of AI‑driven early‑warning systems, integration of real‑time data streams for dynamic model updating, and longitudinal studies to quantify the long‑term impact of uncertainty‑focused practices on organizational project performance.
